+1 281 501-7940

Bulkheads & Seawalls

By Roman Ross — Marine Construction Estimator, Shore Protect Construction

A canal-front property owner on the West Galveston Island canals came to us with a concrete-capped bulkhead that was nearing the end of its life. The cap was cracked across the walkway in several places, the backside soil had washed out far enough that a row of mature palms was sitting on exposed root balls, and the wall was a couple of feet from a tile-clad in-ground spa that nobody wanted to test against pile-driving vibration. The shoreline is tidal — saltwater off West Bay, not a freshwater lake — and that changes both the material spec and the permit path. Below is the full project: why we specified vinyl sheet pile for a Gulf Coast canal, why the existing concrete cap was removed rather than worked around, the as-quoted materials, the phase-by-phase build, honest 2026 pricing, and what TX GLO permitting actually looks like on a Galveston canal.

Bottom line: On a saltwater Galveston canal in 2026, a 100-foot vinyl sheet pile bulkhead replacement runs $350 per linear foot — $35,000 for the wall — plus a separate $3,500 to dismantle the existing concrete cap, for an all-in project of $38,500. Vinyl is specified over treated timber because the saltwater splash zone shortens timber service life by roughly half. The concrete cap comes out because it is already failing and it sits next to a tile spa that will not survive being worked around. Old-bulkhead removal, backfill, and fence work are excluded — they are quoted separately as add-ons.

The Site: 100 LF of Failing Concrete-Capped Bulkhead on a Galveston Canal

The property is a private canal-front lot on the West Galveston Island canals, in Galveston, Texas. This is saltwater — the canal connects to West Bay, the water rises and falls with the tide twice a day, and any material going into the splash zone has to be specified for that. The existing bulkhead is a concrete-capped wall, probably 25 to 30 years old: a poured-concrete walkway cap running the full length of the run, with the wall structure below presumed to be CCA timber based on the era of construction. The cap is cracked at several joints across the walkway and across the spa-side return at the end of the wall, and behind it the soil has been actively washing out for some time.

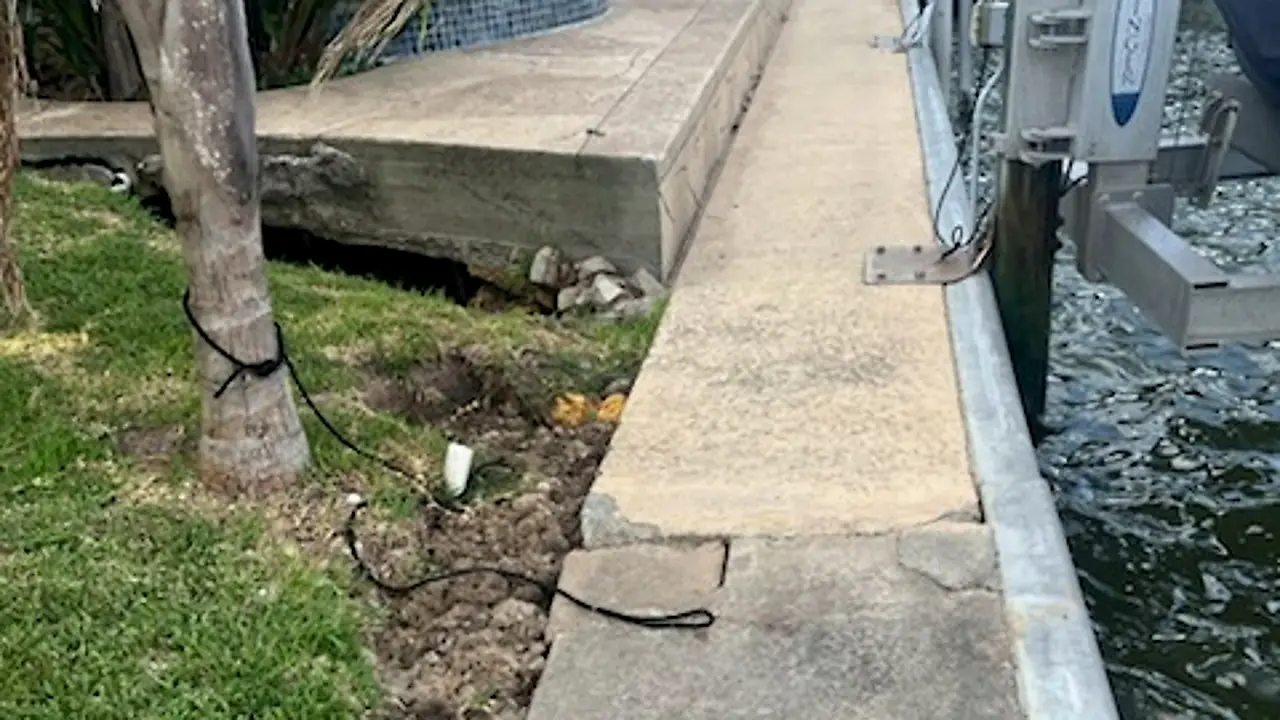

Existing concrete-capped bulkhead on a West Galveston Island canal — visible cracks across the walkway cap and backside soil washout, looking down the canal toward an adjacent boat lift.

The wall runs 100 linear feet along the canal. Wall height is modest — about 2 feet of cap exposed above the waterline and roughly 3 to 3.5 feet down to the canal bottom, so the new sheet pile drives to about 8 to 9 feet of total panel length once embedment is included. The most telling detail from the site walk: behind the cap, the soil voids run two to three feet deep in places, with a row of palms sitting on exposed root balls. That is a wall losing the battle, not a wall that can be repaired in place.

Two site facts shaped the bid. First, land access is excellent — the existing cap walkway carries the equipment, the adjacent lawn stages the materials, and no barge is required. Second, a tile-clad in-ground spa sits within roughly three feet of the wall on the upland side. That dictates a quiet sawcut and plywood shielding for the concrete demo phase — a working clearance that costs a half-day of careful prep and saves a phone call later. Saltwater canal jobs in this corridor are something we cover in our Galveston Island bulkhead construction cost overview; the rest of this post is what those numbers look like on a real ticket.

The Decision: Why Vinyl Sheet Pile for a Saltwater Galveston Canal

For a short-to-mid-height saltwater canal wall like this one — a couple of feet above the waterline, three to four feet below — there are three honest material candidates, and we walk owners through all of them. Treated timber alone is the budget answer but the worst fit on saltwater. Steel sheet pile is structurally over-specified for a five-and-a-half-foot wall and adds equipment cost without proportional payoff. Vinyl sheet pile on a CCA-timber structural frame is the sweet spot here, and the table below is the side-by-side that puts the decision on paper.

Table 1. Material options for a saltwater Galveston canal bulkhead — why vinyl fit this 100 LF wall, 2026 pricing.
Factor Vinyl Sheet Pile Treated Timber Steel Sheet Pile
Typical fit on this profile Short to mid walls, residential canals Short walls, budget jobs Tall walls, ~8 ft and up
Used on this 100 LF project Yes — $350/LF, $35,000 Considered, declined Over-specified for this height
Service life in saltwater PVC face 40–50+ yr; CCA frame 18–25 yr ~15–18 yr in tidal splash Multi-decade, depends on coating
Saltwater corrosion behavior PVC does not corrode; hot-dip galv hardware Surface pitting, faster treatment loss Needs coating or thicker section
Equipment to install Mid excavator with hydraulic clamp Standard crew, no driver Vibratory pile rig + excavator
Maintenance over 30 years One mid-life frame refresh likely At least one full replacement Minimal once coating holds
Best fit Saltwater canals, mid-height residential walls Budget cap on short freshwater walls Tall walls, real retained load
Close-up of the existing concrete cap on the canal-front bulkhead — visible joint cracking and proximity to a tile-clad in-ground spa within roughly three feet of the wall.

For the same vinyl decision on a freshwater Houston-area reservoir, see our vinyl vs concrete bulkhead on Lake Houston, and for the timber-versus-vinyl trade-off on a freshwater Lake Conroe property, our vinyl vs wood bulkhead on Lake Conroe walks through the 30-year math. Same company, same honest pricing logic — the answer changes when you change the water and the wall height.

Why We Remove the Concrete Cap Instead of Building Around It

On a healthy bulkhead, a concrete cap is the sturdiest top finish you can get and it is worth working around. On this one it is the opposite — it is the part of the wall that is failing fastest. The cap is cracked at multiple joints, the backside has lost enough soil that the cap is acting as an unreinforced lip rather than a structural top, and the cracks have already widened where it returns toward the spa. Building a new vinyl wall around a cracked, undermined cap means you have either built a brand-new wall with a 30-year-old failure attached to it, or you have committed to a cap-replacement add-on that doubles back through the same demo zone six months later.

Taking the cap out as part of the project gives the new wall three things: a clean, square tie-in for the new vinyl panels and treated cap board; a single demo phase instead of two; and a chance to inspect what is left of the old wall behind the cap before the new face is set. That last one matters — the old timber posts and walers, if they exist, can be partially salvaged as a soil-retention shim during install, or fully removed if they are too far gone, and that decision is much cheaper made on day one than discovered mid-build.

The cap removal is quoted as a $3,500 lump-sum line separate from the wall price. It covers sawcutting the concrete, breaking it out in sections, and hauling debris away in a dumpster. The work is sequenced before the wall install, with plywood shielding and silt fence between the cap and the adjacent spa for the entire demo phase. The old wall structure below the cap is a separate scope line — see the cost anchor section below — because the decision to pull or leave it gets made on the day, not in the quote.

Materials & Specifications: What Goes Into 100 LF of Vinyl on a Saltwater Canal

Below is the as-quoted material set, straight off the client estimate. Every metal fastener on this job is hot-dipped galvanized, the timber members are CCA pressure-treated to marine-grade retention, and the vinyl panels are UV-stabilized PVC. The dismantling of the existing concrete cap is quoted separately at $3,500 and is not included in the per-foot wall price.

PVC Sheet Pile Wall

  • Vinyl Sheet Pile Panels — UV-stabilized PVC, interlocking, saltwater-rated water-facing skin; 100 LF of coverage
  • 2×12 Cap Board — CCA pressure-treated timber, top finish and walking edge; 100 LF
  • Geotextile Filter Fabric — 8 oz non-woven, behind the panels, prevents soil washout through the interlocks
  • Concrete Set Mix — for post and rear-anchor encasement; project lot

CCA Treated Frame & Tie-Back

  • 6×6 Face Posts — CCA pressure-treated timber, 8 ft long, ~4 ft on-center; about 25 each
  • 6×6 Rear Anchor Piles — CCA pressure-treated timber, 6 ft long, ~8 ft on-center; about 13 each
  • Waler Boards — 2×6 and 3×8 CCA treated timber, 2-row horizontal system; about 200 LF
  • Tie Rods & Hardware — 3/4" hot-dipped galvanized threaded rod, nuts, plate washers; about 13 sets
Schematic cross-section of a typical vinyl sheet pile bulkhead — treated timber cap board through-bolted to the wall, corrugated PVC sheet pile face extending below the waterline, with gravel and soil profile behind and beneath the wall.

Schematic — typical vinyl sheet pile bulkhead cross-section: a treated timber cap through-bolts to corrugated PVC panels, with the embedded length below the waterline carrying the retained load.

Phase-by-Phase Execution Plan

The crew on this job is a foreman, two marine carpenters, and two laborers — five on site. The build runs about 6 working days at a production rate near 25 linear feet per day after the demo phase, and the timeline assumes the TX GLO and City of Galveston permits are already in hand on day one. The work breaks into three phases.

Phase 1 — Site Preparation and Concrete-Cap Removal. The crew mobilizes from Houston to the Galveston property — local mob, no regional uplift. The new wall line is staked along the full 100 LF, plywood shielding and silt fence are placed between the work area and the adjacent tile spa, and the materials are unloaded onto the lawn. The existing concrete cap is sawcut into transportable sections and broken out, working away from the spa side first; debris is loaded into a dumpster. End of day one, the wall is open and ready for the new face.

Phase 2 — Structural Installation. Days two through five are the wall itself. 6×6 CCA-treated face posts are driven into the canal bottom at roughly four feet on-center along the work line, then the interlocking PVC vinyl sheet pile panels are driven between the posts using the excavator-mounted hydraulic clamp. Two rows of CCA-treated waler boards are bolted horizontally across the front of the wall to lock the posts and panels into one stiff plane. The crew then sets the 6×6 rear anchor piles at about eight feet on-center behind the wall and runs 3/4" hot-dipped galvanized threaded rods from the walers back to the anchor piles, tensioning each one with nuts and plate washers so the wall is actively held against soil pressure, not just relying on its embedment.

Phase 3 — Protection & Finish. Day six closes the wall out. 8 oz geotextile filter fabric is set behind the panels to prevent soil washout through the interlocks, and the new 2×12 CCA-treated cap board is fastened along the top of the wall for a clean, square finished edge that also locks the panel tops. Tie-rod tension is checked and final-set. The plywood shielding comes off the spa, the silt fence is removed, the work area is graded back to grade, and the crew performs a final walkthrough with the owner. The wall is finished and the spa is untouched.

Cost Anchor: What 100 LF Costs on a Galveston Canal in 2026

For this 100 LF Galveston canal replacement, the quote came in at $35,000 — $350 per linear foot for the wall, plus a separate $3,500 to dismantle the existing concrete cap, for an all-in project of $38,500. The per-foot number is flat-rate and includes labor, saltwater-rated materials, the mid excavator with hydraulic clamp, the vibratory clamp attachment, dewatering, plywood shielding for the spa, mobilization from Houston, permit coordination, and the five-person crew.

What is not in the wall price, by design, is the work that depends on what we find when the cap comes off. Removing the old bulkhead below the concrete cap is quoted at $20 per linear foot — about $2,000 if the existing timber posts and panels need to come out entirely; if they are sound enough to leave in place as a quiet secondary barrier, the line is zero. Backfill behind the new wall is $10 per linear foot — about $1,000 — and is decided after the wall is up and the soil voids behind the old cap are exposed. Old fence removal and hauling are budget-line add-ons at $30 and $150 respectively. The Galveston cost market is something we cover in more depth in our Galveston Island bulkhead construction cost overview, the Galveston Island bulkhead service overview walks through what we typically deliver on a coastal job, and if you are weighing a heavier wall on a more exposed Bay-side shoreline, the Galveston Island seawall cost page covers the next step up. Short runs under 60 LF and saltwater jobs with water-only access land higher per foot, because fixed costs spread over fewer linear feet.

Lifespan & 30-Year Cost of Ownership

Vinyl sheet pile in saltwater is one of the better cost-of-ownership stories on the coast. The PVC facing does not rot, rust, corrode, or attract marine borers, so the longest-lived part of the wall is the part that takes the daily tidal beating. The CCA-treated timber frame behind it is the shorter-lived piece — the posts, walers, cap, and anchor piles run about 18 to 25 years in a Galveston splash zone before any one of them might need attention. The good news is that those members are accessible and individually replaceable; a mid-life refresh is a targeted repair, not a full wall rebuild.

Key Takeaways — 30-Year Math

  • Vinyl: ~$38,500 upfront, plus one mid-life frame refresh. Budget roughly $8,000 to $12,000 in 2026 dollars around year 20 to refresh waler boards, cap, and any of the timber face members that have surface-pitted. The PVC facing carries on.
  • Treated timber alone would be cheaper today — but wrong for this water. A pure CCA-timber bulkhead in a Galveston canal would face a full replacement cycle inside 15 to 18 years, and that replacement cost typically lands higher than today's vinyl price because saltwater pricing and permitting are not getting cheaper.
  • Concrete is the longest-life answer at 2 to 3× the cost. A poured-concrete bulkhead lasts 40 to 60-plus years and contains no permanent wood. On a residential canal at this height it is over-specified, but it is the right answer for an exposed Bay-side seawall.
  • Hot-dipped galvanized hardware is non-negotiable. Standard zinc-plated fasteners do not survive tidal cycling. Every nut, washer, lag, and tie rod on this job is hot-dipped galvanized, which is why the hardware line reads higher than on a freshwater bid.

TX GLO Permitting on Galveston Canals

Coastal-canal bulkhead work in Galveston is a three-agency review on paper, even when it is a routine like-for-like replacement. The Texas General Land Office has jurisdiction over state-owned coastal submerged lands, the City of Galveston issues the local shoreline permit and verifies setbacks and floodplain elevation, and the U.S. Army Corps of Engineers Galveston District weighs in for any work touching navigable waters. The vast majority of residential canal replacements at this scale qualify under a nationwide permit rather than an individual review, which is what keeps the timeline reasonable. A realistic application-to-approval window is 4 to 6 weeks, and the permit clock — not the build — is what sets the start date.

The mistake we see most often on the coast is owners signing a construction contract and putting down a deposit before the permit application has been filed. That loses the preferred crew window, sometimes pushes the work into hurricane season, and frustrates everybody. Apply for the permit early, then sequence the contract and the crew around the approval letter. For neighboring inland projects on the same trip — where a different regulator and water type apply — see how the same crew handles a freshwater Lake Houston bulkhead, and on a tall freshwater wall with deadman tie-backs the steel bulkhead on Lake Livingston shows where steel sheet pile starts to make sense over vinyl. If your shoreline has a more exposed bay-side profile rather than a tidal canal, our Galveston Island seawall cost page covers the heavier wall option under the same TX GLO process.

Frequently Asked Questions

What does a vinyl bulkhead cost per linear foot on a Galveston canal in 2026?

For this 100 ft vinyl sheet pile replacement on a saltwater Galveston canal — with the existing concrete cap removed and a clean tie-in for the new wall — the quote came in at $350 per linear foot, or $35,000 for the bulkhead work itself, plus $3,500 to dismantle the failing concrete cap, for an all-in project of $38,500. The price covers labor, saltwater-rated materials, the excavator with hydraulic clamp, dewatering, mobilization, and the crew. Old-bulkhead removal below the cap, backfill behind the new wall, and any fence work are quoted separately as add-ons.

Why vinyl instead of treated timber on a saltwater canal?

Treated timber alone works in a Gulf Coast tidal canal, but the splash zone is unforgiving — the same CCA boards that last 25-plus years on a freshwater lake see closer to 15 to 18 years here, and the wall surface stains and pits faster too. A vinyl sheet pile face changes that math. The PVC panels do not rot, do not corrode, do not host marine borers, and carry a 40 to 50-plus year service life in saltwater. The structural frame still uses CCA marine-grade timber for the posts, walers, cap, and anchor piles, but those members are protected by the vinyl face and can be serviced individually over time without replacing the whole wall.

Do you have to remove the old concrete cap, or can you build around it?

On this property the cap had to come out. It was already cracked at multiple joints, undermined from the backside where soil voids had opened behind it, and within a foot or two of an in-ground tile spa that would not survive vibration from sawcutting around it. Removing the cap is cleaner than working around a failing element — it gives the new vinyl wall a square tie-in, lets us set the new treated cap board straight, and removes the failure point instead of leaving it next to a new wall. The dismantle is quoted at $3,500 and includes sawcut, break-out, and haul-away to a dumpster.

How much shorter is the saltwater service life of the timber frame compared with the PVC facing?

Roughly half. UV-stabilized PVC sheet pile in a Galveston canal lasts 40 to 50 years and longer. The same CCA pressure-treated marine-grade timber that gives 25-plus years on a freshwater lake gives more like 18 to 25 years in tidal saltwater splash, because the constant wet-dry cycling drives water deeper into the wood and accelerates the breakdown of the treatment chemistry. The good news is that posts, walers, cap, and anchor piles are accessible from above or behind the wall, so a mid-life refresh of those components is a localized repair, not a full wall rebuild.

Do I need a permit for a bulkhead in a Galveston canal?

Yes. The Texas General Land Office has jurisdiction over state-owned coastal submerged lands, the City of Galveston issues the local shoreline permit, and the U.S. Army Corps of Engineers Galveston District weighs in for any work in navigable waters. A like-for-like replacement on a residential canal usually qualifies under a nationwide permit rather than an individual review, which keeps the timeline manageable — budget 4 to 6 weeks from application to approval. Apply for the permit before signing the construction contract, because the permit clock, not the build itself, is what sets the start date.

How long does the install take, and what is the realistic schedule from quote to finished wall?

The build itself runs about 6 working days — one day for site prep and removing the concrete cap, four days for setting posts, driving the vinyl panels, installing the waler rows, and tying back the anchor piles with tensioned tie rods, and a final day for the geotextile, cap board, and cleanup. The crew is a foreman, two marine carpenters, and two laborers, all on land — no barge required because the bank carries the equipment. Total wall-clock time from quote to finished wall is closer to 8 to 10 weeks once the TX GLO permit review is included; the permit, not the install, is what front-loads the schedule.

Need a Bulkhead on the Texas Gulf Coast?

Shore Protect Construction designs and builds vinyl, timber, and steel bulkheads across the Texas Gulf Coast and inland lakes. TX GLO permit coordination, saltwater-rated material specs that actually last in tidal cycling, and turnkey installation by a crew with over 20 years of marine construction experience. Request a free site estimate and we will put a real number on your shoreline.
