Bulkheads & Seawalls

By Roman Ross — Marine Construction Estimator, Shore Protect Construction

A property owner on Lake Livingston came to us with a tired timber bulkhead and a simple goal: get a new wall in without the cost and mess of tearing the old one out. The existing bulkhead was past its service life — leaning, weathered, losing soil at the waterline — but the upland yard behind it was still intact. That combination is exactly when an in-front steel sheet pile replacement makes sense. Below is the full project: why we specified steel over vinyl or timber, why the new wall was driven in front of the old one, the as-quoted materials, the phase-by-phase build, honest 2026 pricing, and what permitting on Lake Livingston actually looks like.

Bottom line: On Lake Livingston in 2026, a 78-foot steel sheet pile bulkhead driven in front of an existing timber wall runs $767 per linear foot — $59,896 total, all-in, with no demolition. Steel was specified over vinyl and timber because the wall stands roughly 10 feet tall and the lake level swings hard between seasons. The old wood stays in place as a secondary barrier, and clean drainage stone between the two walls is the detail that keeps trapped water from pushing the new wall out.

The Site: 78 LF of Failing Timber Bulkhead on Lake Livingston

The property is a private lakefront lot on Lake Livingston near Coldspring, in San Jacinto County, Texas. This is freshwater — Lake Livingston is a Trinity River reservoir, so there is no tidal action and no saltwater corrosion to design around. The existing bulkhead is an aged timber sheet wall: vertical sheeting with posts at roughly 5-foot spacing, a through-bolted waler band, and a 6x6 timber cap. After years of weathering it is blackened, leaning forward, and staining at the waterline — standing, but well past the point where a repair buys meaningful time.

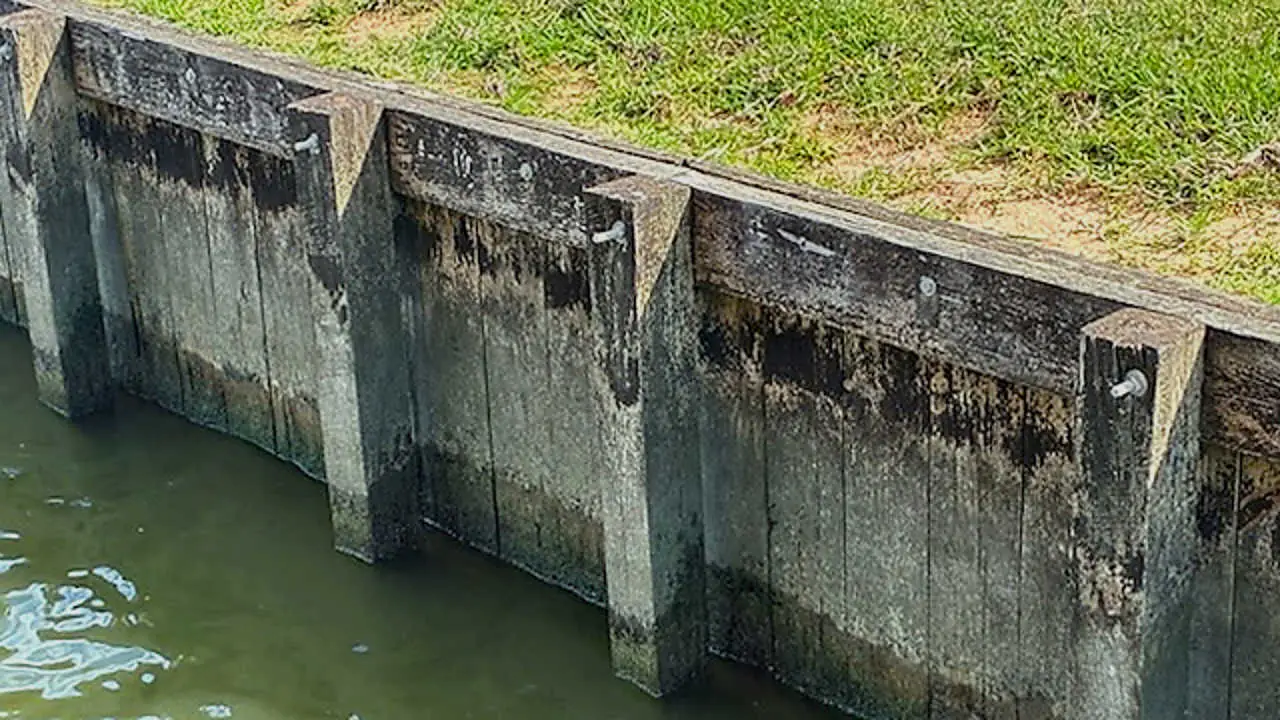

Existing weathered timber sheet-pile bulkhead at the project site on Lake Livingston, Coldspring TX — vertical sheeting and posts past service life, with erosion staining at the waterline.

The wall runs 78 linear feet along the bank — the plat shows 75 feet, but the field measurement came back at 78, and we bid the measured number. Wall height is about 10 feet from the lake bottom to the cap. The owner noted that two years ago, at low pool, it stood as a full 10-foot exposed wall; at the current high water it reads closer to 5 feet above and 5 feet below the surface. That wide seasonal swing matters, and it shaped the material choice.

Two practical site facts shaped the bid. First, land access is excellent — a flat, manicured turf yard runs right down to the water with no slope, no fencing, and no overhead utilities, so equipment stages on the lawn and no barge is required. Second, there is an existing pier with a metal step ladder at the corner that needs a temporary detach and reinstate so the new wall can be spliced through cleanly. We cover local market ranges in our bulkhead construction cost on Lake Livingston overview; the rest of this post is what those numbers look like on a real ticket.

The Decision: Why Steel Sheet Pile for a 10-Foot Freshwater Wall

For a short freshwater wall — a few feet of exposed face — vinyl or treated timber is usually the honest, cost-effective answer, and we recommend them often. This wall is a different animal. At roughly 10 feet tall and holding back a full upland yard, the earth pressure behind the wall is high, and the lake's seasonal swing keeps loading it differently through the year. That is the situation where steel sheet pile earns its higher price: a continuous, interlocked steel face is the stiffest, most predictable way to retain a tall load.

Table 1. Material options for a tall (~10 ft) freshwater bulkhead — why steel fit this Lake Livingston wall.
Factor Steel Sheet Pile Vinyl Sheet Pile Treated Timber
Typical fit by wall height Tall walls, ~8 ft and up Short-to-mid walls Short walls
Used on this 78 LF project Yes — $767/LF, $59,896 Considered Considered
Service life in freshwater Multi-decade 50+ years 15–20 years
Stiffness under a tall earth load Highest — continuous interlocked face Good, but flexes more as height grows Lowest
Tolerance of big lake-level swings Excellent Moderate Limited
Maintenance Minimal None Annual inspection; periodic face repair
Install equipment Vibratory pile rig + excavator Lighter driver Standard crew
Best fit Tall walls, real load, moving water Mid-height freshwater walls Budget-first, short walls
Reference photo: a completed steel sheet pile bulkhead from a past Shore Protect project — not the Coldspring property. Shows interlocking Z-profile sheets and a welded steel cap channel.

Reference photo: a completed steel sheet pile bulkhead from a past Shore Protect project — not the Coldspring property.

If you want the engineering behind the choice, our complete guide to building a waterfront bulkhead walks through anchored versus cantilever design and the full material matrix. And for the same freshwater bulkhead decision on other Texas lakes — where vinyl, timber, and poured concrete were the candidates — see our vinyl vs wood bulkhead on Lake Conroe and our vinyl vs concrete bulkhead on Lake Houston. Same company, same honest math, different walls — and different answers.

Why We Drove the New Wall In Front of the Existing Timber Bulkhead

When an old bulkhead is leaning but the upland soil is still where it belongs, there is rarely a good reason to demolish it. Pulling the legacy sheeting, posts, and buried deadmen means an excavator working the bank for extra days, haul-off fees for the old timber, and rework to soil that gets disturbed in the process — easily $8,000 to $12,000 of avoidable cost on a wall this size. Driving the new steel a hand-span lakeward of the failing structure skips that entire scope.

Leaving the wood in place does more than save money. During construction the old wall acts as a soil-retention shim — it holds the bank and limits settlement while the new sheets are vibrated in. After construction it becomes a quiet secondary barrier behind the steel. This is also why the wall is sheet pile rather than H-pile and lagging: a continuous, interlocked steel face is needed to retain the finer drainage stone that goes into the gap behind it, something a gapped lagging wall cannot do.

One layout detail earns its keep here: end returns. One foot of sheet pile is turned 90 degrees at each end of the run — that is why 80 LF of material covers a 78 LF wall — so water cannot scour around the corners where the new wall meets the neighbors' shorelines. It is a minor cost that heads off a classic washout failure. The other critical detail lives in the gap between the old and new walls, and it is important enough to get its own treatment in the build plan below.

Materials & Specifications: What Goes Into 78 LF of Steel on Lake Livingston

Below is the as-quoted material set, straight off the client estimate. Demolition is $0 — the existing timber wall stays in place. Backfill drainage stone is excluded from the linear-foot price and quoted separately.

Steel Sheet Pile Wall

  • Steel Sheet Pile — Z-section, roughly 22" wide, 10 ft length, light gauge; 80 LF ordered (78 LF wall plus a 1 ft return at each end)
  • Steel Waler / Cap Channel — C10x25 hot-rolled steel channel, welded continuously across the pile heads, full 78 LF run
  • Geotextile Filter Fabric — 8 oz non-woven, behind the sheet pile face, 52 SY

Deadman Tie-Back System

  • Deadman Anchors — 6x6x16 CCA-treated timber, buried 5–6 ft behind the wall, 11 anchors at roughly 7 ft spacing
  • Tie Rods — 3/4" diameter steel, ~14 ft average length, 11 rods
  • Turnbuckles & Anchor Plates — 1" turnbuckle plus 10x10x¼" steel anchor plate, 11 sets
  • Hardware & Welding Consumables — lag screws, spikes, weld rod, and fabrication bulk (hot-dipped galvanized), 1 lot
Reference photo: an excavator-mounted vibratory hammer driving steel sheet pile on a past Shore Protect project — not the Coldspring property.

Reference photo: an excavator-mounted vibratory hammer driving steel sheet pile on a past Shore Protect project — not the Coldspring property. For a closer look at how the legacy timber wall was assessed, see our wood bulkhead deep-dive.

Phase-by-Phase Execution Plan

The crew is a foreman, a pile-driver operator, an equipment operator, a marine carpenter, and two laborers — six on site. The work runs about 8 working days at a production rate near 12 linear feet per day, and the timeline assumes the TRA permit is already in hand on day one. The build breaks into three phases.

Phase 1 — Site Preparation. The crew mobilizes to the Lake Livingston property. The new wall alignment is staked and marked along the full 78 LF, set 6 to 12 inches lakeward of the existing timber face. Materials are staged on the lawn over ground-protection boards, and the excavator is positioned on the bank — land access has been confirmed good, so there is no barge mobilization. The existing pier deck and step ladder are temporarily detached so the new wall can run past the corner cleanly. Permit documentation is on site before any wall steel is unloaded.

Phase 2 — Structural Installation. The Z-section sheet pile is driven in front of the wood using an excavator-mounted vibratory hammer, including the one-foot end returns at each corner. Once the sheets are at grade, the C10x25 steel channel waler is welded continuously across the pile heads, tying the wall into one stiff unit. The crew then excavates the tie-back trenches into the yard, sets the 11 CCA timber deadmen 5 to 6 feet back, runs the 3/4" steel tie rods, and tensions a turnbuckle at every anchor so the wall is actively seated rather than left to lean on embedment alone.

Phase 3 — Protection & Finish. 8 oz geotextile filter fabric is secured behind the sheet pile face to keep fines from migrating through the interlocks. The gap between the old timber and the new steel is filled with clean crushed-stone drainage backfill — quoted as a separate line — so rainwater drains down and out instead of building hydrostatic pressure against the new wall. The pier deck and ladder are reinstated, the tie-back trenches are backfilled and compacted, equipment paths are graded back to the original lawn profile, and the crew performs a final walkthrough with the owner.

Cost Anchor: What 78 LF of Steel Bulkhead Costs on Lake Livingston in 2026

For this 78 LF Lake Livingston replacement, the quote came in at $59,896 — $767 per linear foot. That number is flat-rate and all-in: labor, materials, the vibratory pile-driving rig, the excavator, mobilization, permit coordination, and crew. Demolition is excluded because there is none — the new wall is installed in front of the existing one — and backfill drainage stone behind the new face is a separate scope item (estimated near $2,475 for crushed stone and clean sand).

Steel sheet pile prices higher per foot than vinyl or treated timber, and that is expected: the steel itself costs more, and a tall wall has to be driven with a vibratory pile rig rather than a light crew. What you buy for the difference is stiffness and a service life measured in decades. To see how this fits the wider market, our bulkhead construction cost on Lake Livingston page covers per-foot ranges by material, the Lake Livingston bulkhead service overview walks through what we typically deliver, and the Lake Livingston seawall cost page covers the heavier-wall option for more exposed shoreline. Short runs under about 60 LF and sites with water-only access land higher per foot, because fixed mobilization and rig costs spread over fewer linear feet.

30-Year Total Cost of Ownership

The upfront price is the easy number; the more useful one is what the wall costs over a realistic 30-year ownership window. Steel sheet pile in freshwater is not exposed to the salt corrosion that shortens its life on the coast, so a properly installed wall here is a multi-decade structure with only minimal maintenance. Over a 30-year horizon that means one installation — no replacement cycle to budget for.

Key Takeaways — 30-Year Math

  • Steel: ~$59,896 once. For a tall freshwater wall, a properly installed steel sheet pile bulkhead is a one-and-done install across the 30-year horizon, with maintenance limited to the occasional inspection.
  • Timber would be cheaper today — but wrong for this wall. A 10-foot timber bulkhead on a lake with this much seasonal swing would face a replacement cycle inside 15–20 years, and the structure would never be as stiff.
  • The steel premium buys predictability. The higher upfront cost is the material and the pile rig, not labor padding — a tall wall needs a continuous interlocked face and the equipment to drive it.
  • Steel is the right answer when the wall is tall, the retained load is real, and the water level moves through the year — which is exactly this Lake Livingston site.

TRA Permitting on Lake Livingston

Lake Livingston is a Trinity River Authority reservoir, so any shoreline structure on it is subject to a TRA permit, along with any applicable San Jacinto County requirements. The realistic timeline from application to approval is 4 to 8 weeks, and a basic engineered schematic of the wall is part of a typical submission. The mistake we see most often is owners signing a construction contract before the permit clock has started — that loses the preferred crew window and pushes the work into a less convenient season. Apply for the permit early, then sequence the contract and the crew around it.

If you are weighing related shoreline work on the same property, our Lake Livingston seawall cost page covers the heavier-wall option for more exposed cove segments, and the same TRA process applies.

Frequently Asked Questions

Why choose steel sheet pile over vinyl or timber for a tall freshwater bulkhead?

It comes down to wall height and load. On a short freshwater wall — two or three feet of exposed face — vinyl or treated timber is usually the right call. This Lake Livingston wall is different: about 10 feet from the lake bottom to the cap, holding back a full upland yard. At that height the earth pressure behind the wall is high enough that a continuous, interlocked steel sheet pile face is the most predictable structural answer. Steel also tolerates the lake's wide seasonal swing — this shoreline has gone from a 10-foot exposed wall at low pool to a 5-foot-above, 5-foot-below profile — without the deflection you would have to design around in a tall vinyl wall.

Can a steel bulkhead be installed in front of an existing wood wall without demolition?

Yes, and on this project it was the better option. The new steel sheet pile was driven roughly 6 to 12 inches lakeward of the existing timber bulkhead, which stays in place. Skipping demolition removed an estimated $8,000 to $12,000 of extraction and haul-off cost, and the old wood actually helps during construction — it holds the bank and limits soil movement while the new sheets are vibrated in. The trade-off is layout: the new deadman anchors and tie rods have to be set clear of the legacy wood, which is a survey item handled before stake-out.

What is a deadman tie-back anchor, and how many does a 78-foot steel bulkhead need?

A deadman is a buried timber — here, 6x6x16 CCA-treated — set back from the wall in undisturbed soil. A steel tie rod runs from the wall's waler back to the deadman, and a turnbuckle lets the crew tension it so the wall is actively held, not just relying on the embedded sheet pile. This 78-foot wall uses 11 deadmen spaced about 7 feet on-center, with tie rods averaging roughly 14 feet — long enough to reach soil outside the zone the wall is retaining. Spacing and rod length are driven by wall height and soil conditions, not a fixed formula.

Why is drainage stone placed between the old wood wall and the new steel wall?

When you build a new wall in front of an old one, the gap between them can trap water after heavy rain. Trapped water creates hydrostatic pressure, and a tall sheet pile wall that drains poorly can be pushed — or even ruptured — from behind. Filling that void with clean crushed stone instead of native clay gives the water a path to drain down and out, relieving the pressure. It is one of the most important and most overlooked details on an in-front retrofit. On this job the drainage stone is quoted as a separate backfill line.

What does a steel sheet pile bulkhead cost per linear foot on Lake Livingston in 2026?

For this 78-foot in-front steel replacement on a freshwater Lake Livingston shoreline with excellent land access, the quote came in at $767 per linear foot — $59,896 total. That is an all-in flat rate covering labor, materials, the vibratory pile-driving rig, mobilization, and permit coordination. Steel sheet pile prices higher per foot than vinyl or timber because of the material itself and the heavy equipment a tall wall needs to be driven. Backfill drainage stone is quoted separately. Short runs and water-only access push the per-foot number up.

Do I need a permit for a bulkhead on Lake Livingston?

Yes. Lake Livingston is a Trinity River Authority reservoir, and shoreline structures on it require a TRA permit, along with any applicable San Jacinto County requirements. Budget 4 to 8 weeks from application to approval, and apply before you lock a construction date — the permit timeline, not the build itself, is usually what sets the schedule. A basic engineered schematic of the wall is part of a typical submission.
